Get A Quote
Infralumin Technical Team · Solar Street Light Engineers · Updated March 2025 · 14 min read
A solar street light is only as reliable as its installation. Over years of supplying off-grid solar lighting systems across Sub-Saharan Africa, Southeast Asia, and the Middle East, we have seen well-specified luminaires underperform simply due to avoidable installation errors — a panel tilted in the wrong direction, a concrete foundation poured below the minimum depth, or a controller commissioned without confirming battery state-of-charge first.
This guide is not a generic overview. It is a distillation of the standard operating procedures (SOPs) we ship with every Infralumin solar street light order, structured so that your installation crew — or your subcontractor — can follow them sequentially on-site without needing to contact support.
All SOP steps are numbered and actionable. Items marked ★ in the commissioning checklist are critical — a "No" response on any starred item requires corrective action before the installation is accepted.
Integrated solar street lights — the all-in-one design where panel, battery, controller, and LED head are housed together — have become the dominant product category for off-grid road lighting. Their installation tolerances are tighter than conventional grid-tied streetlights, for three reasons:
In post-installation audits of 1,200+ units across six countries, panels installed at the wrong tilt accounted for 41% of "insufficient brightness" complaints in the first year — more than lamp failure, battery degradation, or controller faults combined.
The panel must face the equator. In the Northern Hemisphere, orient the panel due south (azimuth 180°). In the Southern Hemisphere, orient the panel due north (azimuth 0°/360°). A magnetic compass is sufficient for field orientation — GPS azimuth tools are more accurate but rarely available on rural sites.
On all-in-one solar street lights, the installer sometimes orients the road side of the lamp head forward and assumes the panel faces the correct direction automatically. This is incorrect. The panel azimuth must be confirmed independently of lamp head orientation.
The optimal tilt angle for maximum annual energy yield is approximately equal to the installation site's geographic latitude. However, for all-in-one solar street lights, which have a fixed tilt bracket, the following simplified table applies:
| Latitude Band | Example Countries/Regions | Recommended Panel Tilt | Acceptable Range |
|---|---|---|---|
| 0° – 10° | Singapore, Kenya, Ecuador | 10° | 8° – 15° |
| 10° – 20° | Ghana, Bangladesh, Mexico City | 15° | 12° – 20° |
| 20° – 30° | Saudi Arabia, India (north), Brazil | 25° | 20° – 30° |
| 30° – 40° | Morocco, China, USA (southwest) | 35° | 30° – 40° |
| 40° – 50° | France, Kazakhstan, Canada | 45° | 40° – 50° |
Infralumin all-in-one solar street lights ship with a pre-set 15° bracket as default. If your site latitude requires a different angle, specify this at order time — we manufacture bracket options at 10°, 15°, 25°, and 35°. Post-installation angle adjustment is not possible without replacing the bracket.

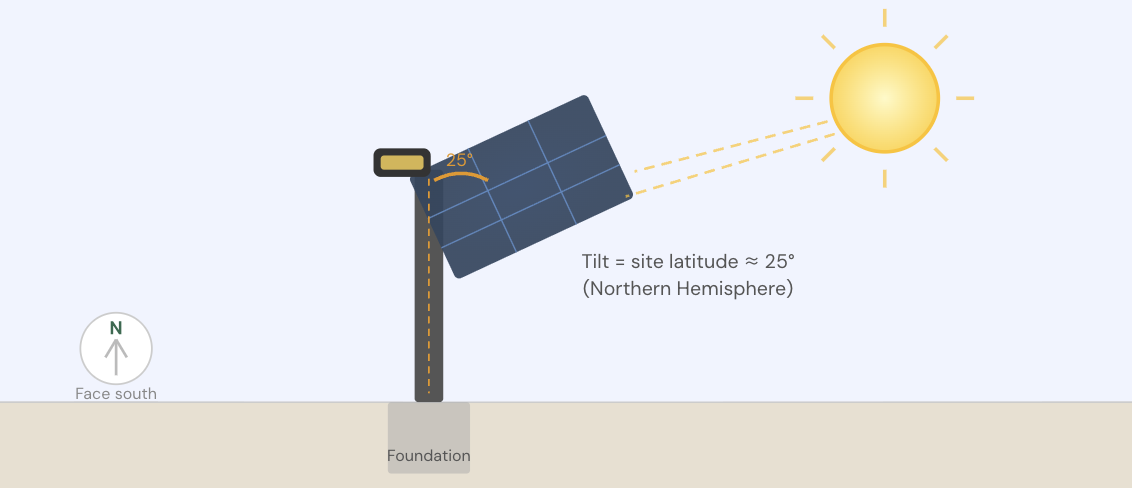

Fig 1. Panel tilt angle equals site latitude. Panel faces equator (south in Northern Hemisphere). Plumb pole ensures vertical alignment.
Conduct a shading assessment at the proposed pole location before breaking ground. Walk the site at 10:00 and 14:00 local solar time. If any tree, building, or overhead cable casts a shadow on the panel during these hours, relocate the pole or prune the obstruction. Even partial shading on one panel cell reduces the entire panel's output due to the series-connected bypass diode architecture.
The foundation is the most labor-intensive part of the installation and the one most frequently under-specified by local subcontractors trying to reduce concrete costs. Under-dimensioned foundations cause pole tilt within 12–18 months in soft or sandy soils — a warranty situation that is entirely preventable.
| Pole Height | Excavation Depth | Excavation Width | Anchor Bolt Circle Dia. | Bolt Size | Min. Concrete Grade |
|---|---|---|---|---|---|
| 4 m | 700 mm | 400 mm × 400 mm | 160 mm | M16 × 600 mm | C20 |
| 5 m | 800 mm | 450 mm × 450 mm | 180 mm | M16 × 700 mm | C20 |
| 6 m | 900 mm | 500 mm × 500 mm | 200 mm | M20 × 800 mm | C25 |
| 7 m | 1,100 mm | 550 mm × 550 mm | 220 mm | M20 × 900 mm | C25 |
| 8 m | 1,300 mm | 600 mm × 600 mm | 250 mm | M24 × 1,000 mm | C30 |
In sandy, laterite, or high water-table soils, increase excavation depth by 25% and use a 4-bolt anchor cage with rebar ties rather than individual J-bolts. Consult the project geotechnical report if available.
1. Mark the pole centerpoint.
Use stakes and string line to mark the centerpoint. Confirm clearance from road edge (minimum 500 mm from asphalt edge for roads <6 m wide; 800 mm for wider roads).
2. Excavate to specified depth.
Use mechanical auger where possible. Clear all loose material from the base. If standing water is present, dewater before pouring.
3. Set anchor bolt cage.
Pre-assemble the 4-bolt cage on a flat surface. Lower cage vertically, centering it over the hole using a temporary timber frame. Verify cage is plumb with a spirit level on both axes before any concrete is placed.
4. Route conduit (if applicable).
If the project includes a control cable or remote monitoring wire, lay a 25 mm corrugated conduit from the base of the hole to a trench leading to the controller cabinet before pouring.
5. Pour concrete in lifts.
Pour concrete in two lifts: fill to 50% depth, rod to remove air pockets, then fill to the top. Do not vibrate — rodding is sufficient for these volumes. Trowel the top surface flat.
6. Cure for minimum 72 hours before mounting pole.
Cover with wet burlap in hot, dry conditions. Do not load the anchor bolts until concrete has reached 70% design strength (typically 72 h at >20°C ambient).
7. Mount pole and torque fasteners.
Slide pole base flange over anchor bolts. Install flat washers, spring washers, and nuts in that order. Torque to specification: M16 → 120 N·m; M20 → 240 N·m; M24 → 420 N·m. Use a calibrated torque wrench — not an impact driver.
8. Verify plumb after tightening.
Check pole vertically on two perpendicular axes with a digital inclinometer or accurate spirit level. Maximum allowable deviation:
2 mm per 1,000 mm of pole height
(i.e., ≤ 12 mm lean at top of 6 m pole). Shim as needed before final torquing.
All-in-one solar street lights arrive with the battery pre-installed in the lamp head. Before mounting the unit on the pole, confirm the following at ground level — it is far more difficult to diagnose electrical issues once the unit is 6 m in the air.
Lithium iron phosphate (LiFePO₄) batteries used in street light units should arrive at ≥ 40% state of charge (SOC). Measure open-circuit voltage at the battery terminals:
| Measured OCV | Approx. SOC | Action |
|---|---|---|
| > 26.0 V (24 V system) | > 80% | ✓ Proceed |
| 24.5 – 26.0 V | 40 – 80% | ✓ Proceed |
| 23.0 – 24.5 V | 10 – 40% | ⚠ Charge before commissioning |
| < 23.0 V | < 10% | ✗ Check for cell damage; contact supplier |
Never connect the LED driver output to the battery terminals directly to "test the light." This bypasses the controller's over-discharge protection and may permanently damage the battery or trigger thermal runaway.
Commissioning is the structured process of confirming that the installed system operates within design parameters before it is handed over to the client or project owner. The checklist below mirrors IEC 60364-6 (Initial Verification) principles adapted for off-grid solar street lighting.
Items marked ★ are critical. A "Fail" on any critical item requires corrective action and re-inspection before acceptance.
Based on field audit data from 40+ projects, these are the five most frequent installation errors and their fixes:
Concrete needs time to consolidate around the anchor bolt cage. Rushing this step (often driven by per-unit day-rate contracts) produces voids around the bolts that become critical failure points. Fix: Make concrete curing a contractual milestone with photographic evidence required before pole erection sign-off.
As noted earlier, the panel azimuth and the lamp head direction are independent on all-in-one designs. Fix: Use a compass app on the panel surface — not the road — before tightening the lamp arm bolt.
Installers sometimes overtighten IP glands trying to ensure waterproofing, which splits the inner rubber grommet and actually creates a water ingress path. Fix: Tighten gland until finger-tight, then one additional quarter-turn with a spanner — no more.
Programming the controller while shading the panel to "simulate night" and force the light on is incorrect — the controller's time-keeping reference is calibrated on the first charge cycle. Fix: Allow the unit to go through one natural dusk-to-dawn cycle before adjusting the dimming schedule, or use the manufacturer's mobile app to configure timing directly.
Ground resistance testing requires a dedicated clamp tester and takes less than 90 seconds, yet it is omitted on most sites. In lightning-prone environments (common in tropical Africa and Southeast Asia), an inadequate earth path means the controller and LED driver absorb the surge. Fix: Include grounding resistance as a contractual acceptance criterion with a recorded result required on the handover form.
Every specification in this guide reflects real failure modes that we have observed and corrected on live projects. The commissioning checklist above is derived from the same QC form used by our factory team for pre-shipment inspection — adapted for field use.
If you are planning a solar street lighting project and want factory-level installation support, Infralumin offers project technical consultation, site-specific SOP packages, and on-request training for installation crews.
Solar Lighting Engineers · infralumin.com
The Infralumin technical team has designed, manufactured, and deployed off-grid solar street lighting systems since 2012. Our engineers hold certifications in IEC 60364 electrical installation, and our factory is ISO 9001-certified. All installation guidance published on this site is reviewed annually against field audit data from active project portfolios.
Standards & References
